Kendall Square at MIT

Cambridge, MA
Official construction updates during the creation of 1 million square feet of new space in Kendall Square.
Developer
Phase
Construction
Open Space
Over 1.8 acres
retail
115,000 SQ FT
office
/ R&D 888,000 SQ FT
residential
450 grad & 290 other

Construction Update: October 6th – October 20th

Please note, no work will take place on Monday, October 9th in observance of Columbus Day.

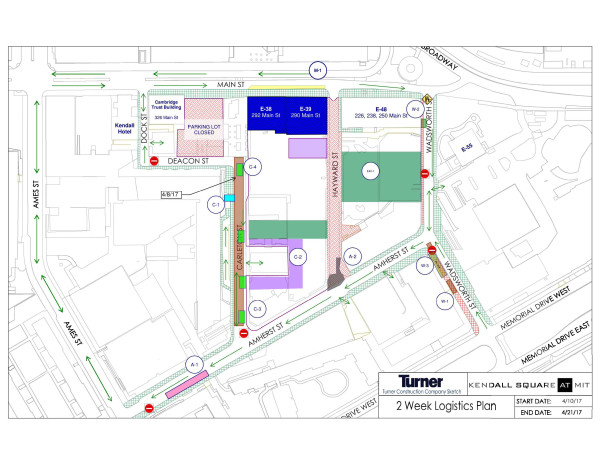

Street and Sidewalk Impacts

Wadsworth Street –The street will remain closed to vehicular traffic from Amherst Street to Memorial Drive (between Buildings E51 and E52) 24 hours a day until certain unforeseen conditions are managed and resolved. The project team anticipates this work to last at least 2-3 more weeks. Construction activities include equipment set up and staging for utility installation. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. (W1).

Utilities will continue to be installed on the north side of Wadsworth Street towards Main Street (W2). The work will require a lane to be occupied and fenced in due to the depth of the excavation. The sidewalk will remain open and there will be no pedestrian detour, vehicle traffic will be limited to one way from Main Street to Amherst Street.

Amherst Street – A steam manhole will continue to be installed just to the south of E23. This work is scheduled to take another few weeks to complete. The driveway to the Media Lab may be slightly impacted but vehicles and pedestrians will have access around the work area. (A1)

Work will begin at 100 Memorial Drive across from Carleton Street to install a new utility structure. Pedestrians will be rerouted around the construction zone while the work takes place. (A2)

General Construction Update

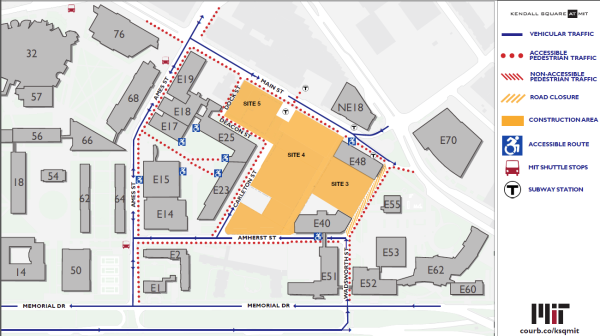

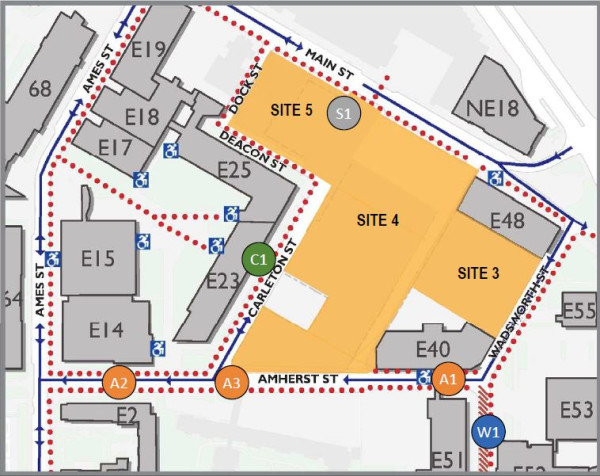

The slurry wall and secant wall installation will continue at Site 5 (S1) This work may create vibration in the immediate area. We anticipate sheeting operations to begin in late October along Main Street.

The sheeting installation activities will commence on Site 4 (bordered between Carleton, Main, Hayward and Amherst Streets) (S2). This work may create noise and vibration in the immediate area.

Work continues on the Kendall Garage behind 290-292 Main (E38-E39), and 238 Main (E48). This includes:

  • Slurry Wall installation.
  • Daily deliveries of steel and concrete.
  • Daily trucking to remove material from the site.

E38 interior and exterior renovation activities will continue.

E39 foundation activities will continue.

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.

Saturday Work – General construction activities will continue on Saturdays. Work will occur within the City of Cambridge allowable work hours, 9:00 am to 6:00 pm.

MBTA Main Street Plaza – The pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is closed fully for the duration of the project to allow construction of an underground garage in this area. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Deacon/Dock Street, or Wadsworth Street.

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

Construction Update: September 21th - October 6th

Street and Sidewalk Impacts

Wadsworth Street –The street will remain closed to vehicular traffic from Amherst Street to Memorial Drive (between Buildings E51 and E52) 24 hours a day until certain unforeseen conditions are managed ad resolved. The project team anticipates this work to last at least 2-3 more weeks. Construction activities include equipment set up and staging for utility installation. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. (W1).

Utilities will continue to be installed on the north side of Wadsworth Street towards Main Street (W2). The work will require a lane to be occupied and fenced in due to the depth of the excavation. The sidewalk will remain open and there is no pedestrian detour, vehicle traffic will be limited to one way from Main Street to Amherst Street.

Carleton Street –The excavation between Carleton Street and the driveway ramp to E23/E25 will continue to be restored (C1). This will require some noisy activities and possible temporary ramp impacts to occur. Any ramp work will utilize police details to maintain traffic flow.

Amherst Street – Chilled water installation and survey work will take place along Amherst next to E40 and E51. (A1) Access to the buildings will remain open but pedestrians may need to be detoured to alternate routes during the work.

On Friday, 9/22 and Sunday, 9/24, the project will be performing a chilled water shutdown and tie-in. This work will require the E40 main entrance on Amherst Street to be closed while the work occurs (A4). Access and egress to the building will be coordinated during this work.

Chilled water (A2) and gas (A3) utilities will continue from Ames Street to Wadsworth Street.

A steam manhole will be installed in the grassy area just to the south of E23. This work is scheduled to take a week to complete. The driveway to the Media Lab may be slightly impacted but vehicles and pedestrians will have access around the work area. (A5)

Work will begin at 100 Memorial Drive to install an ejector pit.

General Construction Update

The slurry wall and secant wall installation will commence on Site 5 (former Cambridge Trust site) starting the week of 9/25 (S1) This work may create vibration in the immediate area. We anticipate sheeting operations to begin in late October along Main Street.

The pre-trenching work ahead of the sheeting installation activities has been changed to commence on Site 4 (bordered between Carleton, Main, Hayward and Amherst Streets) (S2). Sheeting installation is scheduled to commence in this area on October 2nd. This work may create noise and vibration in the immediate area.

Work continues on the Kendall Garage behind 290-292 Main (E38-E39), and 238 Main (E48). This includes:

  • Slurry Wall (Support of the Excavation) installation.
  • Daily deliveries of steel and concrete.
  • Daily trucking to remove material from the site.

E38 interior and exterior renovation activities will continue.

E39 Foundation activities will continue.

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.

Saturday Work – General construction activities will continue on Saturdays. Work will occur within the City of Cambridge allowable work hours, 9:00 am to 6:00 pm.

MBTA Main Street Plaza – The pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is closed fully for the duration of the project to allow construction of an underground garage in this area. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Deacon/Dock Street, or Wadsworth Street.

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

Construction Update: September 8 - September 21

Street and Sidewalk Impacts

Wadsworth Street –The street will remain closed to vehicular traffic from Amherst Street to Memorial Drive (between Buildings E51 and E52) 24 hours a day until the end of September. Construction activities include equipment set up and staging for utility installation. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. (W1).

Utilities will continue to be installed on the north side of Wadsworth Street towards Main Street (W2). The work will require a lane to be occupied and fenced in due to the depth of the excavation. Pedestrians will be detoured to the opposite side of the street during this work and vehicle traffic will be limited to one way from Main Street to Amherst Street.

Carleton Street –The excavation between Carleton Street and the driveway ramp to E23/E25 will continue to be restored (C1). This will require some noisy activities and possible temporary ramp impacts to occur. Any ramp work will utilize police details to maintain traffic flow.

Amherst Street – Chilled water installation and survey work will take place along Amherst next to E40 and E51. (A1) Access to the buildings will remain open but pedestrians may need to be detoured to alternate routes during the work.

On Saturday, 9/16, the project will be performing a chilled water shutdown and tie-in. This work will require the E40 and E51 main entrances on Amherst Street to be closed while the work occurs (A4). Access and egress to both buildings will be coordinated during this work.

Chilled water (A2) and gas (A3) utilities will continue from Ames Street to Wadsworth Street.

General Construction Update

Earth support preparation will commence on Site 5 (former Cambridge Trust site) followed by slurry wall and secant wall installation starting the week of 9/18 (S1) This work may create vibration in the immediate area. We anticipate sheeting operations to begin in late October along Main Street.

The pre-trenching work ahead of the sheeting installation activities has been changed to commence on Site 4 (bordered between Carleton, Main, Hayward and Amherst Streets) (S2). Sheeting installation is scheduled to commence in this area on September 25th. This work may create noise and vibration in the immediate area.

Work continues on the Kendall Garage behind 290-292 Main (E38-E39), and 238 Main (E48). This includes:

  • Slurry Wall (Support of the Excavation) installation.
  • Daily deliveries of steel and concrete.
  • Daily trucking to remove material from the site.

E38 interior and exterior renovation activities will continue.

E39 Foundation activities will continue.

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.

Saturday Work – General construction activities will continue on Saturdays. Work will occur within the City of Cambridge allowable work hours, 9:00 am to 6:00 pm.

MBTA Main Street Plaza – The pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is closed fully for the duration of the project to allow construction of an underground garage in this area. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Deacon/Dock Street, or Wadsworth Street.

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

Construction Update: August 24th – September 8th

Street and Sidewalk Impacts

Wadsworth Street –The street will remain closed to vehicular traffic from Amherst Street to Memorial Drive (between Buildings E51 and E52) 24 hours a day until mid-September. Construction activities include equipment set up and staging for excavation and utility installation. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. (W1).

Carleton Street –The excavation between Carleton Street and the driveway ramp to E23/E25 will begin to be restored (C1). This will require some noisy activities and possible temporary ramp impacts to occur. Any noisy work will occur before 10am and any ramp work will utilize police details to maintain traffic flow.

Amherst Street – Chilled water installation and survey work will take place along Amherst next to E40 and E51. (A1) Access to the buildings will remain open but pedestrians may need to be detoured to alternate routes during the work.

On Saturday, 8/26, the E40 main entrance on Amherst Street will be closed while work occurs. The rear entrance will be fully accessible during this time.

Chilled water (A2) and gas (A3) utilities will continue from Ames Street to Wadsworth Street.

General Construction Update

Sheeting installation will commence on Site 5 (former Cambridge Trust site) starting along Main Street (S1) This work may create noise and vibration in the immediate area.

Work continues on the Kendall Garage behind 290-292 Main (E38-E39), and 238 Main (E48). This includes:

  • Slurry Wall (Support of the Excavation) installation.
  • Daily deliveries of steel and concrete.
  • Daily trucking to remove material from the site.

E38 interior and exterior renovation activities will continue.

E39 Foundation activities will continue.

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.

Saturday Work – General construction activities will continue on Saturdays. Work will occur within the City of Cambridge allowable work hours, 9:00 am to 6:00 pm.

MBTA Main Street Plaza – The pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is closed fully for the duration of the project to allow construction of an underground garage in this area. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Deacon/Dock Street, or Wadsworth Street.

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

Construction Update: August 3rd - August 18th

Street and Sidewalk Impacts

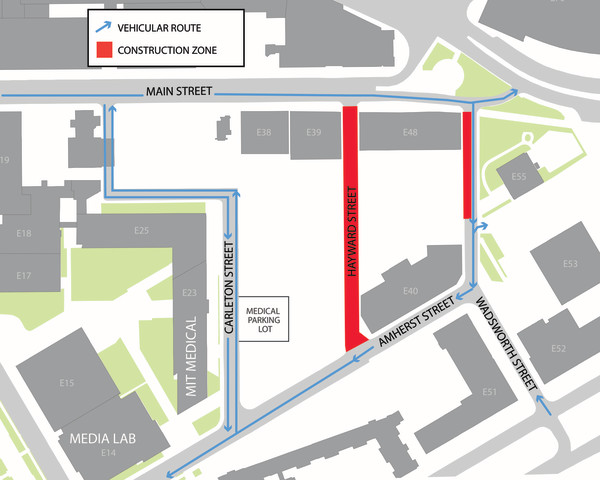

Wadsworth Street –The street will remain closed between Amherst Street and Memorial Drive (between Buildings E51 and E52) 24 hours a day to vehicular traffic. We anticipate the closure to remain in place until late August. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. For the duration of excavation and installation Wadsworth Street will remain closed as a location for equipment set up and staging. (W1).

Utility exploratory work will occur on the corner of Wadsworth and Amherst Streets (W2). Pedestrian and vehicular traffic will be maintained during this work.

Carleton Street – Utility work on the street includes chilled water (C1) and gas line (C2) installation. Carleton Street will remain open to vehicular traffic from Amherst Street to the Medical Parking Lot.

MBTA Main Street Plaza – The pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is closed fully for the duration of the project to allow construction of an underground garage in this area. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Dock Street, or Wadsworth Street. (M1)

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

General Construction Update

Work continues on the Kendall Garage behind 290-292 Main (E38-E39), and 238 Main (E48). This includes:

  • Slurry Wall (Support of the Excavation) installation.
  • Daily deliveries of steel and concrete.
  • Daily trucking to remove material from the site.

Pre-trenching for the slurry wall and sheeting installation will continue on site 5. This work may create noise and vibration in the immediate area.

E38 Interior and exterior renovation activities will continue.

E39 Foundation activities will continue.

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.

Saturday Work – General construction activities will continue on Saturdays. Work will occur within the City of Cambridge allowable work hours, 9:00 am to 6:00 pm.

Construction Update: July 29th – August 3rd

Street and Sidewalk Impacts

Wadsworth Street –The street will remain closed between Amherst Street and Memorial Drive (between Buildings E51 and E52) 24 hours a day to vehicular traffic. We anticipate the closure to remain in place until mid-late August. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. For the duration of excavation and installation Wadsworth Street will remain closed as a location for equipment set up and staging. (W1).

Utility exploratory work will occur on the corner of Wadsworth and Amherst Street (W2). Pedestrian and vehicular traffic will be maintained during this work.

Carleton Street – Utility work on the street includes chilled water (C1) and gas line (C2) installation. Carleton Street will remain open to vehicular traffic from Amherst Street to the Medical Parking Lot.

Excavation and rerouting of an existing sanitary line will take place. There should be minimal impact on pedestrian or vehicular traffic. (C2).

Main Street – Sidewalk protection will continue to be installed on Main Street. Pedestrians will be routed to the inside of the sidewalk during this work.

MBTA Main Street Plaza – The pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is closed fully for the duration of the project to allow construction of an underground garage in this area. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Dock Street, or Wadsworth Street. (M1)

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

General Construction Update

Work continues on the Kendall Garage behind 290-292 Main (E38-E39), and 238 Main (E48). This includes:

  • Slurry Wall (Support of the Excavation) installation.
  • Daily deliveries of steel and concrete.
  • Daily trucking to remove material from the site.

Foundation preparation work will continue on site 5.

E38 Interior and exterior renovation activities will continue.

E39 Foundation activities will re-commence as structural demolition has been completed.

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.

Saturday Work – General construction activities will continue on Saturdays. Work will occur within the City of Cambridge allowable work hours, 9:00 am to 6:00 pm.


Construction Update: July 14th - July 28th

Street and Sidewalk Impacts

Wadsworth Street –The street will remain closed between Amherst Street and Memorial Drive (between Buildings E51 and E52) 24 hours a day to vehicular traffic. We anticipate the closure to remain in place until mid-late August. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. For the duration of excavation and installation Wadsworth Street will remain closed as a location for equipment set up and staging. (W1).

Electrical utilities will continue to be installed including a duct bank across Wadsworth Street and a new utility pole on the east (E55) side of the street (W2). Pedestrian and vehicular traffic will be maintained during this work.

Carleton Street – Utility work on the street includes gas line (C1) and chilled water (C2) installation. Carleton Street will remain open to vehicular traffic from Amherst Street to the Medical Parking Lot.

Amherst Street – Sanitary installation (A1) will continue on the south (100 Memorial Drive) side of the street. Chilled Water piping installation (A2) will continue. Pedestrian detours will be in place as the work progresses down the street but at least one side of the sidewalk will be available to pedestrians at all time. Eversource will continue to install gas services (A3) on Amherst Street towards Wadsworth Street.

Main Street – Sidewalk protection will continue to be installed in front of the old Cambridge Trust Building. Pedestrians will be routed to the inside of the sidewalk during this work.

MBTA Main Street Plaza – The pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is closed fully for the duration of the project to allow construction of an underground garage in this area. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Dock Street, or Wadsworth Street. (M1)

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

General Construction Update

Saturday Work – General construction activities will continue on Saturdays. Work will occur within the City of Cambridge allowable work hours, 9:00 am to 6:00 pm.

Demolition will commence on the Cambridge Trust Building (M2) This work should take approximately one week to be complete.

  • Pedestrian detours may be implemented during portions of this work.
  • A large excavator along with smaller support equipment will be used to dismantle the structure.
  • Water will be used during this activity for dust control.


Structural demolition on 290 Main (E39) will commence.

  • Water will be used during this activity for dust control.


Work continues on the Kendall Garage behind 292 Main (E38), and 238 Main (E48). This includes:

  • Slurry Wall (Support of the Excavation) installation.
  • Daily deliveries of steel and concrete.
  • Daily trucking to remove material from the site.


Scaffolding will continue to be installed on the face of E38 / E39 buildings.

Site work will continue on site 5 (behind Cambridge Trust).

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.


Construction Update: July 3rd - July 7th

Street and Sidewalk Impacts:

Deacon Street to Carleton Street Pedestrian Closure - Starting the week of July 3rd, the sidewalk and the ramp leading to the main entrance of MIT Medical Building E23/E25 off Carleton and Deacon Street will be closed during the work day for a week to allow for the demolition of the existing ramp in preparation for utility installation. The temporary ramp off of Deacon Street will be reopened at the end of the day and permanently once the demolition of the old ramp is completed.

Wadsworth Street –The street will be reopened from July 3rd through July 9th due to the July 4th holiday. After July 9th, the street will remain closed between Amherst Street and Memorial Drive (between Buildings E51 and E52) 24 hours a day to vehicular trafficWe anticipate the closure to remain in place until mid-late August. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. For the duration of excavation and installation Wadsworth Street will remain closed as a location for equipment set up and staging. (W1).

Carleton Street – Utility work on the street includes electrical duct bank installation (C1) and chilled water (C2).

Amherst Street – Sanitary installation (A1) will continue on the south (100 Memorial Drive) side of the street. Chilled Water piping installation (A2) will continue. Pedestrian detours will be in place as the work progresses down the street but at least one side of the sidewalk will be available to pedestrians at all time. Eversource will continue to install gas services (A3) on Amherst Street towards Wadsworth Street.

Main Street – Sidewalk protection will continue to be installed in front of the old Cambridge Trust Building. Pedestrians will be routed to the inside of the sidewalk during this work.

MBTA Main Street Plaza - The pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is closed fully for the duration of the project to allow construction of an underground garage in this area. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Dock Street, or Wadsworth Street. (M1)

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

Carleton Street will remain open to vehicular traffic from Amherst Street to the Medical Parking Lot.


General Construction Update -

Saturday Work- General construction activities may continue on Saturdays. Work will occur within the City of Cambridge allowable work hours, 9:00 am to 6:00 pm.

Demolition will commence on the Cambridge Trust Building (M2) This work should take approximately one week to be complete.

Work continues on the Kendall Garage behind 292 Main (E38), and 238 Main (E48). This includes -

·        Slurry Wall (Support of the Excavation) installation.

·        Daily deliveries of steel and concrete.

·        Daily trucking to remove material from the site.

Selective demolition on 290 Main (E39) will begin.

Steel will continue to be installed in E38 / E39.

Scaffolding will be installed on the face of E38 / E39 buildings.

Site work will continue on site 5 (behind Cambridge Trust).

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.


Construction Update June 19th – June 30th:

Street and Sidewalk Impacts:

MBTA Main St. Plaza - The pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is closed fully for the duration of the project to allow construction of an underground garage in this area. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Dock Street, or Wadsworth Street. (M1)

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

Carleton Street will remain open to vehicular traffic from Amherst Street to the Medical Parking Lot.

MIT Medical Building– The stair repair for the MIT Medical Building (C3) will be complete the week of June 19th.

Starting the week of June 26th, the ramp leading to the main entrance off Carleton and Deacon Street will be closed during the work day for a week to allow for demolition activities in preparation for utility installation. The temporary ramp off of Deacon Street will be reopened once the demolition of the old ramp is completed.

Wadsworth Street –The street will remain closed between Amherst Street and Memorial Drive (between Buildings E51 and E52) 24 hours a day to vehicular traffic. We anticipate the closure to remain in place until mid-late August. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. For the duration of excavation and installation Wadsworth Street will remain closed as a location for equipment set up and staging. (W1).

Carleton Street – The street will remain closed to all traffic except for the Medical Building Parking Lot and emergency services. Utility work on the street includes water line repairs (C1) and electrical duct bank installation (C2).

Amherst Street – Sanitary installation (A1) will continue on the south (100 Memorial Drive) side of the street. Chilled Water piping installation (A2) may begin. Pedestrian detours will be in place as the work progresses down the street but at least one side of the sidewalk will be available to pedestrians at all time.

Eversource will continue to install gas services (A3) on Amherst Street towards Wadsworth Street.



General Construction Update -

Saturday 6/17/17 - The crane installing the slurry wall on Wadsworth Street will be moved from Wadsworth Street to the garage site via Amherst Street. This activity will take approximately 30 minutes.

Work continues on the Kendall Garage behind 292 Main (E38), 290 Main (E39), and 238 Main (E48). This includes -

·        Slurry Wall (Support of the Excavation) installation.

·        Daily deliveries of steel and concrete.

·        Daily trucking to remove material from the site.

Steel will continue to be installed in E38 / E39.

Scaffolding will be installed on the face of E38 / E39 buildings.

Site work will continue on site 5 (behind Cambridge Trust).

Interior demolition will continue in the Cambridge Trust Building.

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.


Construction Update: June 5 - 17, 2017

MBTA Plaza

On Monday, June 12th, the pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is scheduled to close fully to allow construction of an underground garage in this area. The path in this area was recently narrowed and will now fully close for the duration of the project. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Dock Street, or Wadsworth Street.

Access to the MBTA station and elevator will remain open and accessible on the Main Street side of the station throughout this work.

Carleton Street will remain open to vehicular traffic from Amherst Street to the Medical Parking Lot.



Construction Update June 5th through Saturday June 17th



Street and Sidewalk Impacts:

Wadsworth St. –The street will remain closed between Amherst Street and Memorial Drive (between Buildings E51 and E52) 24 hours a day to vehicular traffic. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. For the duration of excavation and installation, Wadsworth Street will remain closed as a location for equipment set up and staging. (W1).

Carleton St – The street will remain closed to all traffic except for the Medical Building Parking Lot and emergency services. Utility work on the street includes water line repairs (C1) and electrical duct bank installation (C2).

The stair repair for the MIT Medical Building (C3) will begin the week of June 12th.

Amherst St. - Forced Sanitary installation (A1) will continue on the south (100 Memorial Drive) side of the street. Chilled Water piping installation (A2) may begin. Pedestrian detours will be in place as the work progresses down the street.

Eversource will continue to install gas services (A3) towards Ames Street beyond Carleton Street.



 General Construction Update -

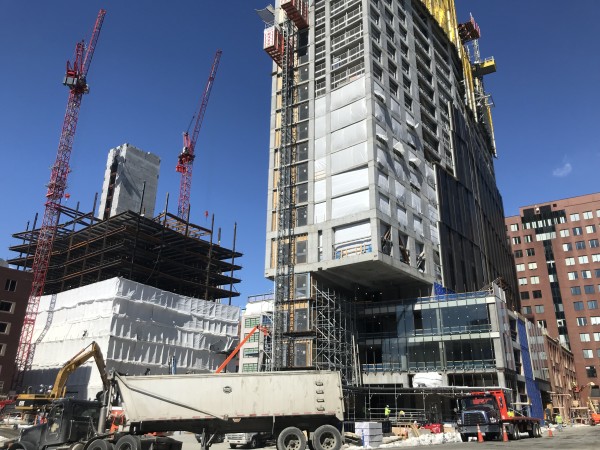

 Work continues on the Kendall Garage behind 292 Main (E38), 290 Main (E39), and 238 Main (E48). This includes -

  • Slurry Wall (Support of the Excavation) installation.
  • Daily deliveries of steel and concrete.
  • Daily trucking to remove material from the site.

Steel will continue to be installed in E38 / E39.

Scaffolding will be installed on the face of E38 / E39 buildings.

Site work will continue on site 5 (behind Cambridge Trust)

Interior demolition will continue in the Cambridge Trust Building

Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.

MBTA Station: Pedestrian Access Change

On Monday, June 12, the pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is scheduled to close fully to allow construction of an underground garage in this area. The path in this area was recently narrowed and will now fully close for the duration of the project. Pedestrians will be guided to seek alternate paths to and from the station using Ames Street, Dock Street, or Wadsworth Street. See attached map of suggested routes.


Access to the MBTA station will remain open and accessible on the Main Street side of the station throughout this work.


Carleton Street will remain open to vehicular traffic from Amherst Street to the Medical Parking Lot.



Construction Update: May 19 - 29, 2017

Wadsworth Street 24/7 closure from Amherst to Memorial Drive

On Wednesday May 24th, Wadsworth Street between Amherst Street and Memorial Drive (between Buildings E51 and E52) will be closed 24 hours a day for approximately 3 months to vehicular traffic. The Project will be installing new utilities and will need to utilize large equipment in order to perform this work. Vehicles on Memorial Drive should access the Kendall Square area via Ames Street. Please see the map below to see the driving pattern for the area. The street will not be reopened at the end of each day or on weekends.



Construction Update May 22nd through Saturday June 3rd

Street and Sidewalk Impacts:

Carleton Street – Storm Drain work will continue through the week of May 22nd. This will require Carlton St to be closed to all traffic except for the Medical Building Parking Lot.

Amherst Street -  Forced Sanitary installation will continue on the south (100 Memorial Dr.) side of the street. Pedestrian detours will be in place as the work progresses down the street. Eversource will continue to install gas services towards Ames St beyond Carlton St.

Wadsworth Street – In addition to the work stated above, electrical work will continue which will limit traffic North to South only (Main to Amherst).

Dock Street – Utility work will be performed in order to prepare for the demolition of the Cambridge Trust Building.

MBTA Plaza – The area has been narrowed to allow the project to prepare for new construction zones.




General Construction Update:

 Work continues on the Kendall Garage within the closed parking lots behind 292 Main (E38), 290 Main (E39), and 238 Main (E48). This includes -

  • Slurry Wall (Support of the Excavation) installation.
  • Daily deliveries of steel and concrete.
  • Daily trucking to remove material from the site.
  • Steel will begin to be installed in E38 / E39.
  • Scaffolding will be installed on the face of E38 / E39 buildings.
  • Site work will begin on site 5 (behind Cambridge Trust).
  • Police details will be utilized throughout the project area to assist with pedestrian and vehicular traffic.

Check out how MIT is building a Better World

On your next visit to Kendall Square check out the MIT Better World walkway on Main Street between the MBTA station and Hayward Street. Through the summer we are displaying just a few of the incredible innovations going on at MIT, including gravitational wave discoveries at LIGO, new strategies for delivering clean water, new Alzheimer's disease treatments, and a way to bring this all to the world; The Engine. Details and links to other exciting resources are available on the Kendall Square Initiative website.

Lots more information about the education, research, teaching, and innovation at MIT is available at the MIT News website and from the MIT Campaign for a Better World.

#MITBetterWorld

Pedestrian and Vehicular Route Changes

Please note the following activities and access changes in the Kendall Square area at the MBTA Kendall Square Station and on Wadsworth Street related to Kendall Square construction activities. Construction hours are scheduled for 7AM – 6PM weekdays with some Saturday work from 9AM – 6PM as needed.


MBTA Station Pedestrian Access from Carleton Street

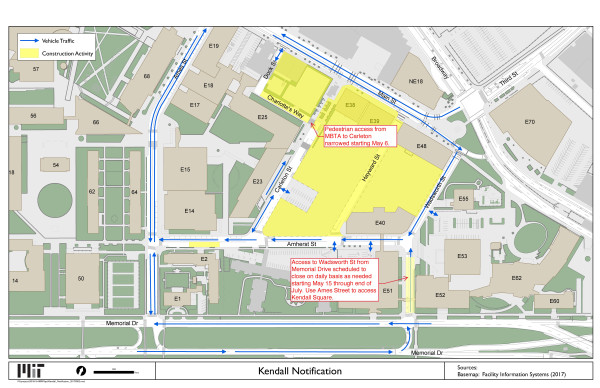

On Saturday, May 6, a portion of the pedestrian plaza connecting Carleton Street to the inbound Kendall Square MBTA Station on Main Street is scheduled to close to allow construction of an underground garage in this area. An ADA-accessible 10-foot wide pedestrian pathway between the MBTA station and Carleton Street will remain open for the next few weeks. Access to the station will also remain open and accessible on the Main Street side of the station.

In the coming weeks the plaza in this location may close to pedestrian traffic. We will send updated notifications when the work is confirmed and scheduled. At that time pedestrians will be guided to seek alternate paths to and from the station using Ames Street or Wadsworth Street. Access to the MBTA station will remain available throughout this work.

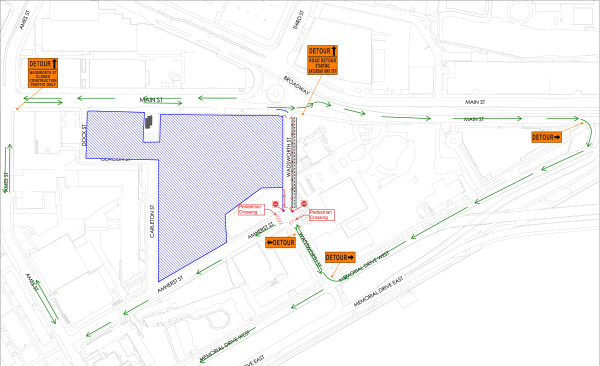

View the attached map showing the narrowed pedestrian walkway between the MBTA station and Carleton Street. Carleton Street will remain open to vehicular traffic from Amherst Street to the Medical Parking Lot.


Wadsworth Street temporary closure at Memorial Drive

On Tuesday, May 9, the block of Wadsworth Street between Amherst Street and Memorial Drive (between Buildings E51 and E52) is scheduled to be closed temporarily to vehicular traffic. Starting Monday, May 15 the same area will begin daily closures that are expected to continue through the end of July. During this period access to Wadsworth from Memorial will be closed as needed on a daily basis. Drivers on Memorial Drive should access the Kendall Square area via Ames Street. Please see the attached map showing the driving pattern for the area.


Cambridge Trust Bank opens in new location May 15

On Monday, May 15, the Cambridge Trust Bank is scheduled to open at their new location at 415 Main Street, next to Sebastians. The current location at 326 Main Street is scheduled to close on Friday, May 12 and plans are underway to demolish the existing building later this month.


Thank you for your patience during the Kendall Square construction work. These changes are making way for new buildings and the creation of green spaces just south of Main Street in the center of Kendall Square. The current site of the Cambridge Trust Bank will become the future home of the MIT Museum and MIT Press bookstore, along with other offices and groups, providing a welcoming entry when folks emerge from the MBTA station into Kendall Square. A new below-grade garage will provide parking for daily users and visitors with dedicated spaces for electric and low-emitting vehicles. Learn more about the project plans in this news article.

Traffic pattern change 5/1 - 5/3

From Monday, 5/1 through Wednesday, 5/3 during working hours of 7am - 6pm, the block of Wadsworth Street between Amherst St and Memorial Drive will be closed to all vehicular traffic to accommodate excavation equipment operating in the street. Drivers on Memorial Drive who wish to access points north should enter the site via Ames Street.


Starting Thursday, 5/4, this block of Wadsworth St will resume one-lane traffic traveling north from Memorial Drive during working hours.

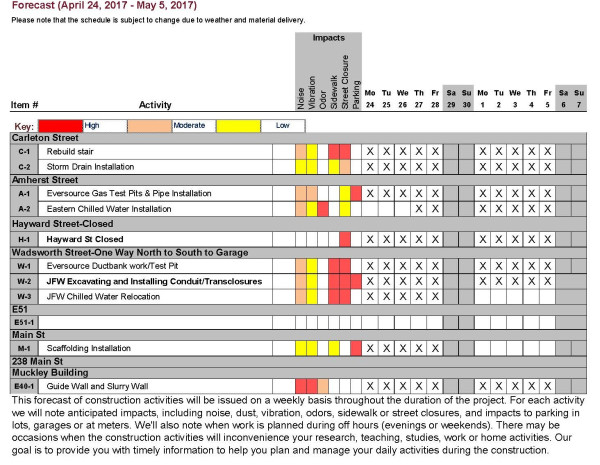

Construction Update: April 24 - May 5

See the chart and map below for work occurring over the next two weeks (click the image for larger versions!)

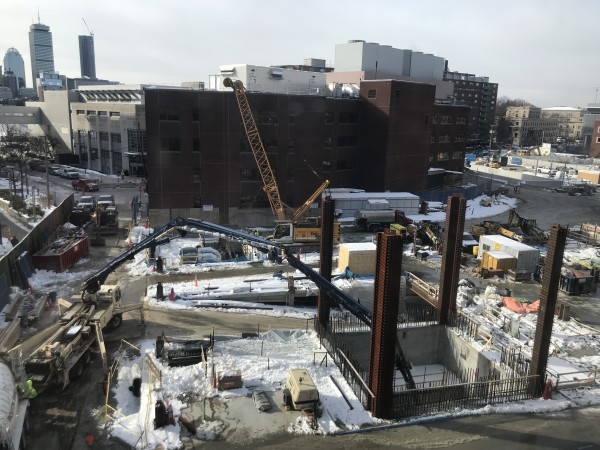

Work has begun on the Kendall Garage within the closed parking lots behind 292 Main (E38), 290 Main (E39), and 238 Main (E48).

Click to download the 2-Week Lookahead Map and the corresponding 2-Week Lookahead Chart.

Major Operations Include:

  • Excavation and Flow Filling of Guide Wall Trenches
  • Carleton St storm drainage installation and excavation. Carleton Street will be closed during the day from the Cambridge Trust parking lot to the Medical building
  • Wadsworth St test pits which will involve use of vac truck equipment
  • Wadsworth St sanitary line installation next to the Tang Building, south of Amherst St


Traffic Routes Include:

  • Carleton St: Closed to traffic from Main St to the Medical Parking Lot; access to the Medical Parking Lot only available from Amherst St
  • Hayward St: Closed to all vehicular and pedestrian traffic
  • Wadsworth St: One-way traffic from Memorial Drive to Amherst St (south to north traffic only); one-way traffic from Main Street to Amherst St (north to south only)
  • Amherst St: One-way traffic between Wadsworth St and Ames St

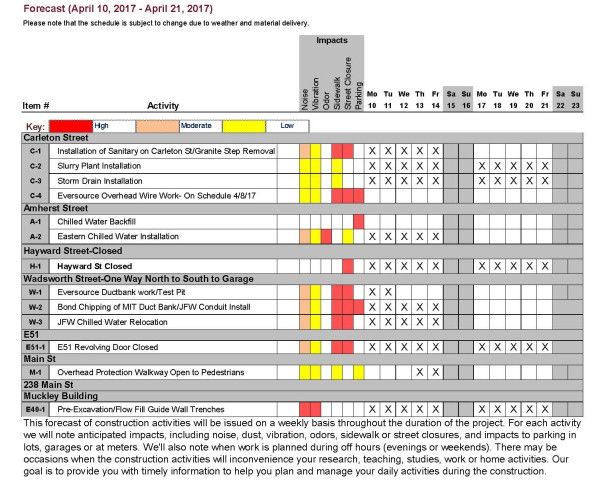

Construction Update: April 10 - April 21

See the chart and map below for work occurring over the next two weeks (click the image for larger versions!)

Work has begun on the Kendall Garage within the closed parking lots behind 292 Main (E38), 290 Main (E39), and 238 Main (E48).

Click to download the 2-Week Lookahead Map and the corresponding 2-Week Lookahead Chart.

Major Operations Include:

  • Excavation and Flow Filling of Guide Wall Trenches
  • Carleton St Sanitary Installation and Excavation. Carleton St Closed during day from Cambridge Trust Lot to Medical Lot. Pedestrians to use ADA ramp while granite steps are removed for work.
  • Wadsworth south of Amherst One-Way running North from Memorial Drive for Eversource Duct bank work.


Traffic Routes Include:

  • Carleton St: Closed to traffic from Main St to the Medical Parking Lot; access to the Medical Parking Lot only available from Amherst St
  • Hayward St: Closed to all vehicular and pedestrian traffic
  • Wadsworth St: One-way traffic from Memorial Drive to Amherst St (south to north traffic only); one-way traffic from Main Street to Amherst St (north to south only)
  • Amherst St: One-way traffic between Wadsworth St and Ames St

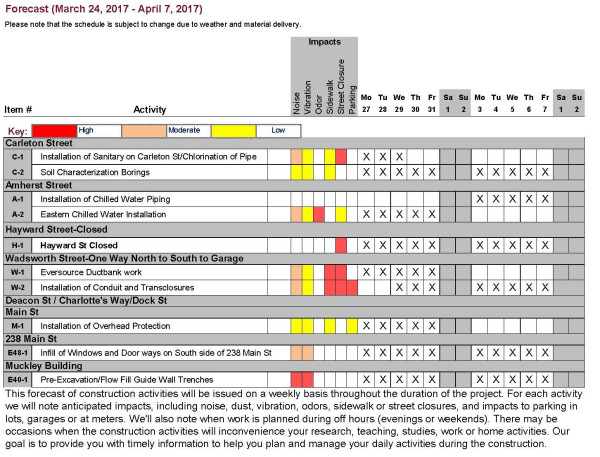

Construction Update: Mar 27 - April 7

See the chart and map below for work occurring over the next two weeks (click the image for larger versions!)

Work has begun on the Kendall Garage within the closed parking lots behind 292 Main (E38), 290 Main (E39), and 238 Main (E48).

Click to download the 2-Week Lookahead Map and the corresponding 2-Week Lookahead Chart.

Major Operations Include:

  • Excavation and Flow Filling of Guide Wall Trenches
  • Carleton St Sanitary Installation and Excavation. Carleton St Closed during day from Cambridge Trust Lot to Medical Lot
  • Wadsworth south of Amherst One-Way running North from Memorial Drive for Eversource Duct bank work.


Traffic Routes Include:

  • Carleton St: Closed to traffic from Main St to the Medical Parking Lot; access to the Medical Parking Lot only available from Amherst St
  • Hayward St: Closed to all vehicular and pedestrian traffic
  • Wadsworth St: One-way traffic from Memorial Drive to Amherst St (south to north traffic only); two-way traffic from Amherst St to Main St
  • Amherst St: One-way traffic between Wadsworth St and Ames St




Construction Update: Mar 13 - Mar 24

See the chart and map below for work occurring on Carleton, Wadsworth, and Amherst Streets over the next two weeks (click the image for larger versions!)

Work has also begun on the Kendall Garage within the closed parking lots behind 292 Main (E38), 290 Main (E39), and 238 Main (E48).

Click to download the 2-Week Lookahead Map and the corresponding 2-Week Lookahead Chart.

Major Operations Include:

  • Excavation and Flow Filling of Guide Wall Trenches
  • Carleton St Sanitary Installation and Excavation. Carleton St Closed during day from Cambridge Trust Lot to Medical Lot
  • Wadsworth south of Amherst One-Way running North from Memorial Drive for Eversource Duct bank work.

Traffic Routes Include:

  • Carleton St: Closed to traffic from Main St to the Medical Parking Lot during structural demolition of E34; access to the Medical Parking Lot only available from Amherst St
  • Hayward St: Closed to all vehicular and pedestrian traffic
  • Wadsworth St: One-way traffic from Memorial Drive to Amherst St (south to north traffic only); two-way traffic from Amherst St to Main St
  • Amherst St: One-way traffic between Wadsworth St and Ames St

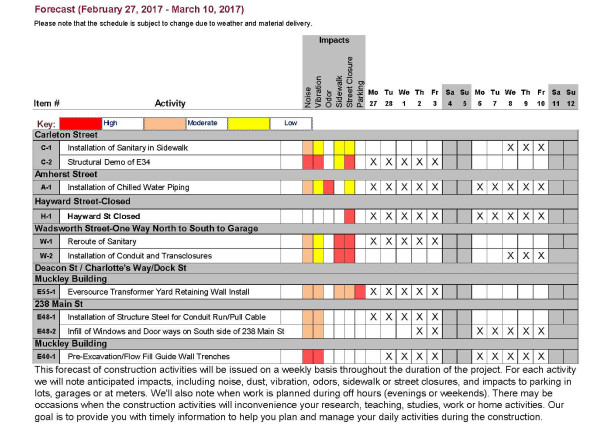

Construction Update: Feb 27 - March 10

See the chart and map below for work occurring on Carleton, Wadsworth, and Amherst Streets over the next two weeks (click the image for larger versions!)

Work has also begun on the Kendall Garage within the closed parking lots behind 292 Main (E38), 290 Main (E39), and 238 Main (E48).

Click to download the 2-Week Lookahead Map and the corresponding 2-Week Lookahead Chart.

Major Operations Include:

  • Site excavation behind the Muckley Building (E40) for the Kendall Garage
  • Demolition of E34 and partial closure of Carleton St as a result
  • Sanitary utility relocation on Wadsworth Street next to Tang (E51)
  • Chilled water utility installation on Amherst St in front of Senior House (E2)

Traffic Routes Include:

  • Carleton St: Closed to traffic from Main St to the Medical Parking Lot during structural demolition of E34; access to the Medical Parking Lot only available from Amherst St
  • Hayward St: Closed to all vehicular and pedestrian traffic
  • Wadsworth St: One-way traffic from Memorial Drive to Amherst St (south to north traffic only); two-way traffic from Amherst St to Main St
  • Amherst St: One-way traffic between Wadsworth St and Ames St

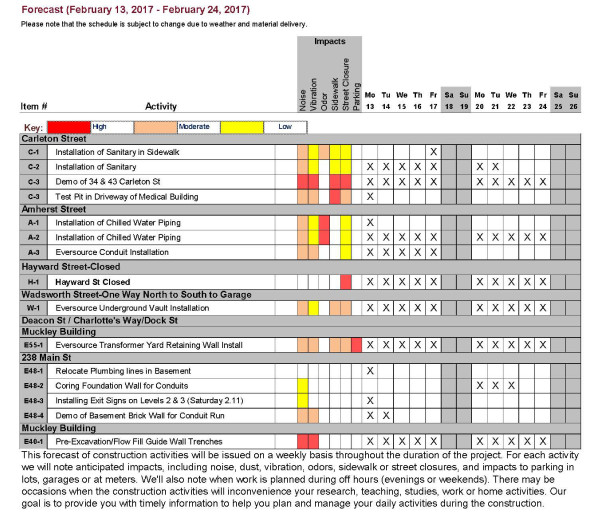

Construction Update: Feb 13 - Feb 24

See the chart and map below for work occurring on Carleton, Wadsworth, and Amherst Streets over the next two weeks (click the image for larger versions!)

Work has also begun on the Kendall Garage within the closed parking lots behind 292 Main (E38), 290 Main (E39), and 238 Main (E48).

Click to download the 2-Week Lookahead Map and the corresponding 2-Week Lookahead Chart.

Major Operations Include:

  • Pre-trenching and site excavation behind the Muckley Building (E40) for the Kendall Garage
  • Demolition of E33 and E34
  • Sanitary utility installation on Carleton St in front of the Medical Building (E23)
  • Chilled water utility installation on Amherst St in front of Senior House (E2)


Traffic Routes Include:

  • Carleton St: One-way traffic between Main St and the Medical Parking Lot; two-way traffic between the Medical Parking Lot and Amherst St
  • Hayward St: Closed to all vehicular and pedestrian traffic
  • Wadsworth St: One-way traffic between Main St and the Herman Garage; two-way traffic between the Herman Garage and Amherst St
  • Amherst St: One-way traffic between Wadsworth St and Ames St



New EZ Ride & Tech Shuttle Bus Stops: Feb 2017

Beginning Monday, Feb. 6th, EZ Ride and Tech Shuttle bus routes will not go to the Kendall Square T stop and to any stops previously located on Amherst St between Wadsworth St and Ames St.

New routes for the EZ Ride Morning, Midday, and Evening Routes can be downloaded here. A new route for the Tech Shuttle can be downloaded here. All new routes are shown below.

There will be 3 new stops added to the routes:

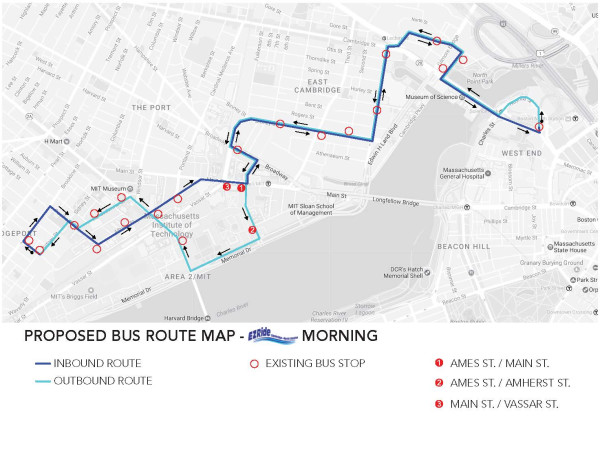

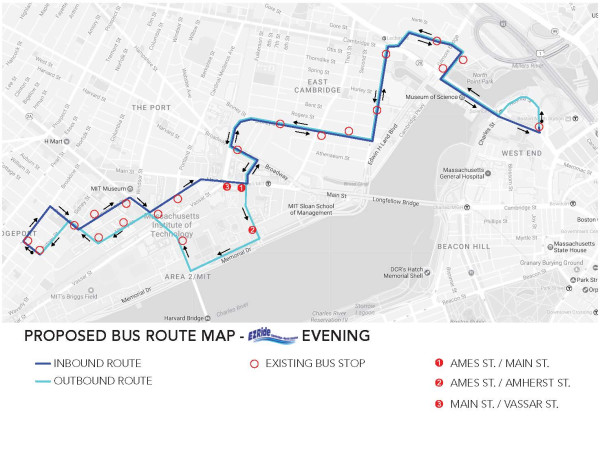

  1. Ames St @ Main St
  2. Ames St @ Amherst St
  3. Main St @ Vassar St


Thank you!

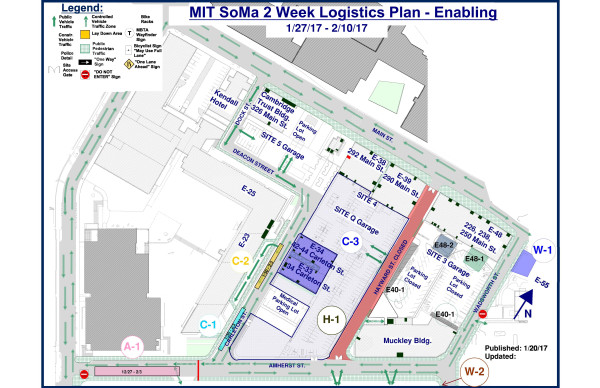

Construction Update: January 30 - February 10

See the chart and map below for work occurring on Carleton, Wadsworth, and Amherst Streets over the next two weeks (click the image for larger versions!)

Work has also begun on the Kendall Garage within the closed parking lots behind 292 Main (E38), 290 Main (E39), and 238 Main (E48).

Click to download the 2-Week Lookahead Map and the 2-Week Lookahead Chart.


Traffic Pattern Update: Hayward Street closed 1/30

Traffic Patterns as of 1/30/2017

Hayward Street will be closed from Main Street to Amherst St to all vehicular and pedestrian traffic beginning Monday, January 30th until further notice. Hayward Street will only be accessed by Turner Construction vehicles for the duration of the Kendall utilities and garage construction.

Wadsworth Street will re-open to one-way vehicular traffic from Main Street to Amherst Street. For residents of Eastgate and users of the Sloan Campus parking garage, access to the parking lot and garage on Wadsworth Street will be maintained from both directions.

Thank you for your patience as Kendall Square continues to grow!

Traffic Pattern Update: Hayward Street One-Way

Traffic Patterns as of 1/24/2017

Starting tomorrow, January 24th, Hayward Street will become one-way, north-to-south, from Main Street to Amherst Street.

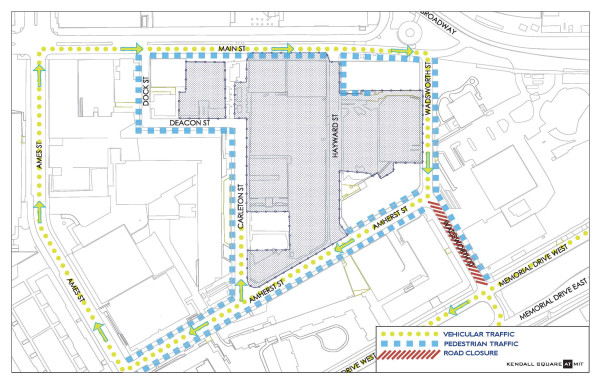

The current traffic patterns are in place on all streets in the Kendall construction zone:

  • Carleton Street: Two-way traffic maintained via police detail
  • Hayward Street: One-way traffic maintained north to south (Main St to Amherst St), beginning 1/24/2017
  • Wadsworth Street: Closed to traffic from Main Street for portion of the street. One-way traffic maintained south to north (Memorial Drive to Wadsworth St) on the open portion of the street, with access into the Eastgate / Sloan Campus parking lot.
  • Amherst Street: One-way traffic maintained east to west from Wadsworth St to Ames St.


Regular traffic patterns are maintained on Main Street, Dock Street, and Charlotte's Way / Deacon Street.

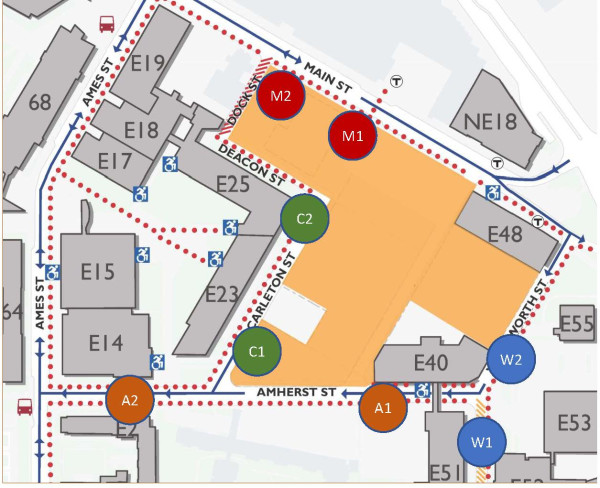

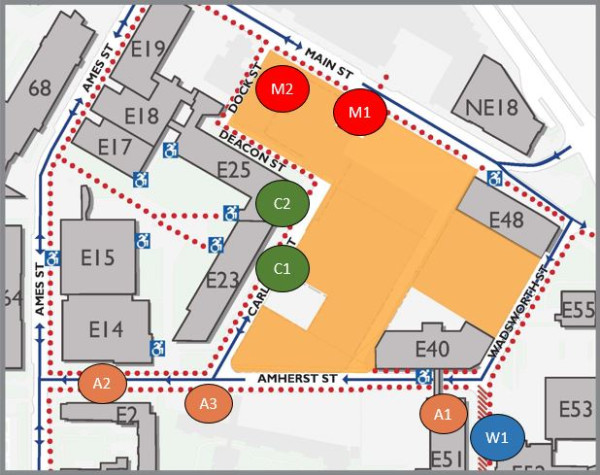

Construction Update: January 16-27, 2017

NEW FORMAT BELOW!

Click to download Two-Week Lookahead Impact Chart and Map of Work.

Starting this week we are trying out a new means of communicating project updates. Below you will find a list of activities occurring on site, organized by street. Each activity marks which days it will occur over the next two weeks, and what impacts to expect. The impact categories for each activity include the following:

  • Noise
  • Vibration
  • Odor
  • Sidewalk Closure
  • Street Closure
  • Parking Impact


Activities are coded and you can refer to the map below for a visual of each of the coded activities. If you are most concerned about work on Carleton Street, for example, you can simply refer directly to the Carleton Street section for a quick glance of what to expect.

We will update the chart of activities every two weeks and post them here. You may also download the chart and the map if you wish to enlarge or save either document. These can be found under Information & Plans on the CoUrbanize home page.


Construction Update: January 1-15, 2017

Happy New Year! Work continues on Amherst, Carleton, and Hayward Streets in January. To download the construction map, please click here.

As work increases both in the street and for the start of the Kendall Garage, we will begin to issue construction updates twice per month to keep the public informed of the ongoing work. This scope covers work to expect over the next two weeks.

The scope of work includes:

  • Chilled water pipe installation on Amherst St in front of Senior House (E2)
  • Sanitary pipe installation on Amherst St in front of 100 Memorial Drive apartments
  • Water pipe installation on Carleton St in front of MIT Medical (E23)
  • Water pipe installation on Hayward St next to Muckley Building (E40)
  • Eversource work in Charlotte's Way (Deacon St) next to the Kendall Hotel and Eversource work in Wadsworth St next to Eastgate


Street closures include the following:

  • Wadsworth St from Main St to the entrance of the Eastgate/Sloan parking lot will be closed while Eversource digs a trench for a new electrical ductbank. Access to the parking lot will be maintained from the south, via Memorial Drive. Please see Update #8 for more details.
  • Two way traffic will be maintained on all streets where possible, via traffic flagmen to direct traffic.


Parking lot and on-street parking impacts include the following:

  • The parking lot behind 290 Main St & 292 Main St (E38 & E39) remain closed.
  • The Hayward Annex Lot and the lot behind 238 Main St (E48) are closed as of 1/4/17.
  • Wadsworth St on-street parking is removed during construction of the Eversource ductbank.
  • Amherst St on-street parking is removed during construction of the chilled water and sanitary pipes from Senior House to 100 Memorial Drive.
  • RPP-only parking has been added to Ames Street to accommodate the loss of on-street parking for residents in the area.


Please feel free to reach out to us here or at kendallsquare@mit.edu with any further questions. Thank you!

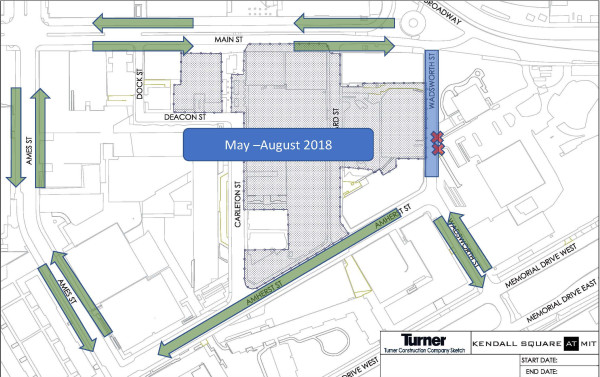

Wadsworth St Temporary Closure

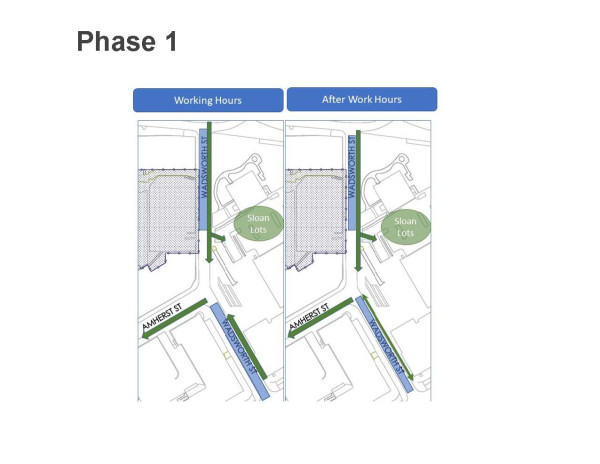

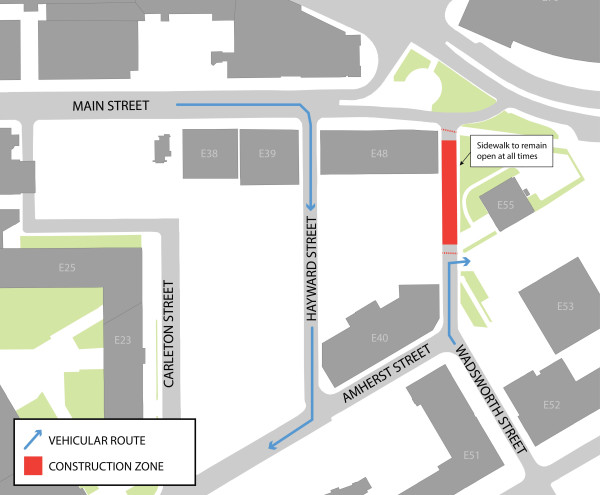

Starting approximately Tuesday, January 3rd, the section of Wadsworth St between Main St and the backside of 238 Main (E48), shown above, will be closed. The street closure is to allow Eversource to install a new electrical ductbank across Wadsworth St that will connect a temporary transformer yard to 238 Main St and provide temporary power to both 238 Main and the future Kendall Garage during construction.

Eversource will ensure that one sidewalk on either side of Wadsworth Street will remain open at all times. Traffic from Memorial Drive to Wadsworth St will still be able to access the parking lot associated with Eastgate and the Sloan campus, and traffic coming down Main Street from either direction will be re-routed down Hayward St for anyone looking to reach Amherst St and Memorial Drive.

This work will take approximately 4-5 weeks to complete, at which point Wadsworth St will be re-opened to traffic. Thank you!

Construction Update: December 2016

To download the construction map, please click here.

Construction in Kendall Square will take place on Amherst, Carleton, and Wadsworth Streets through December.

The scope of work includes:

  • Installation of new water lines in Carleton & Hayward Street
  • Installation of chilled water lines in Amherst Street, between Ames St & Carleton St
  • Installation of new sanitary lines in Amherst St, between Carleton St & Wadsworth St


Traffic patterns put in place include the following:

  • North-to-south one-way traffic on Carleton St (from Main St towards Amherst St)
  • East-to-west one-way traffic on Amherst St (from Sloan towards the Media Lab)
  • South-to-north one-way traffic on Hayward St (from Amherst St towards Main St)


At least one sidewalk will remain open to pedestrians on all streets through the duration of this work. Work hours will commence from 7am - 6pm daily, although most days work on-site is complete by 3pm.

The new MIT medical parking lot is open across from E23 on Carleton Street, and the entire Hayward Lot parking lot has been closed. Handicap ramps will be installed in front of E23 to direct handicap pedestrians to the medical parking lot.

Thank you as always for your patience with construction, and please reach out if you have any questions or concerns!

Update on Food Truck Relocations

Food Trucks are on the Move!

Beginning Monday, November 28 find food trucks Jose’s Mexican, Momogoose, and Jerusalem Café at these new locations:

• Between E14 & E23 (Media Lab & MIT Medical, at Amherst and Carleton Street)
• Between Buildings 56 & 66 (in North Court)
• Between Buildings 14 & 50 (Hayden & Walker, just south of McDermott Court)

Trucks will rotate locations on a weekly basis, with one truck at each location through the first week in January. If the sites are a success, these locations will remain active for the next couple of years.

The food trucks typically operate from 11:00 am – 3:00 pm, Monday-Friday.

Please email foodstuff@mit.edu with any questions or feedback about the new locations.

Visit here for more information, including a map of the new locations: http://studentlife.mit.edu/dining/retail-dining/food-trucks-are-move.

Construction Update:  November 2016

Construction will continue for the Kendall Square at MIT project this month with the installation of new water piping on Carleton and Hayward Streets and continued installations of utilities on Amherst Street.

A few quick notes for the public:

* We will be converting certain metered parking spaces to RPP spaces on Ames Street, across the street from the Media Lab, to replace RPP spaces temporarily removed on Amherst Street to accommodate the construction zones.

* The remaining portion of the Hayward Lot will close in early November, and all of the Medical parking spaces will be re-located to the new Medical parking lot located across the street from E23.

* One-way traffic on Carleton and Hayward Streets will be established as work zones begin to be erected.

* Temporary utility poles will be erected on Carleton and Wadsworth Street to accommodate the transition of overhead to underground electrical and low-voltage lines, but these poles will not impede pedestrian access on those sidewalks.

And more details, if you're interested:

There will be work in the intersections of Carleton/Amherst and Hayward/Amherst Streets over the next two weeks as we excavate and install water piping at those intersections. During those work periods, traffic will be carefully routed down Amherst Street with the use of police details to go around the mid-street work zones.

By mid-November, we also plan to be continuing in Amherst Street with further utilities installations that started in September. Like the first work zone, this will be on the south side of Amherst Street and will work its way east toward Wadsworth Street.

If you have any questions regarding the construction work on site, please contact Alison Crowley at: acrowley@mitimco.mit.edu.

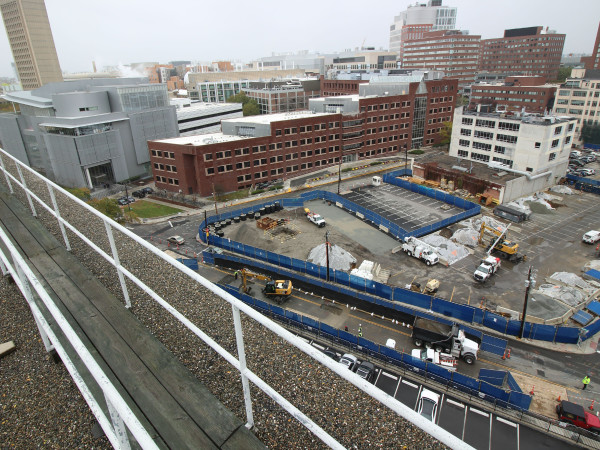

Work zone image captured on 10/28/16 at 11:30am.

Community Meeting Update: October 18, 2016

The Kendall Square at MIT project team will host two community meetings to discuss construction impacts and the future of Kendall Square next Tuesday, October 18th!

Please join us at one of two sessions we'll be hosting during the following times:

Venue: E25-111

Time: 11:45 am - 12:45 pm OR 6:00 pm - 7:00 pm

Refreshments will be provided.

We look forward to sharing with all MIT students, staff, and faculty, as well as Cambridge community residents who want to learn more about what to expect during construction and to learn more about the Kendall Square Initiative and the development projects that are underway.

Construction Update: October 2016

Construction has started in Kendall Square! You may have seen blue fencing erected around the Hayward Street Lot and on a portion of Amherst Street. Along with that fencing, here's what's happening in October:

* Amherst Street is now one-way, east to west, through the end of 2016. We will be installing new utilities in the south side of the street and during that time, on-street parking will be temporarily removed.

* A new parking lot for visitors to the MIT Medical building (E23) has been constructed next to E33 and E34 and will be accessible from Carleton Street throughout the duration of construction.

* The remainder of the Hayward Lot will be fenced off for construction equipment and materials in the first week of October.

* Carleton Street will become one-way, north to south, beginning this month as a single lane is captured for the new installation of utilities. As always, ambulance access to E23 will be maintained, and vehicles parking in the new Medical parking lot will have access.

If you have any questions regarding the construction work on site, please contact Alison Crowley at: acrowley@mitimco.mit.edu.

To download the October 2016 construction map below, please click here.

Construction Update: September 2016

Beginning after Labor Day, construction will begin at Kendall Square! Through September 2016, you may see the following:

* Fencing to be erected on Carleton, Amherst, and Hayward Streets to create a laydown area for Turner Construction to bring materials and equipment.

* Trees and bushes will be removed next to E33 (34 Carleton St) and on Hayward Street to accommodate temporary construction curb cuts for truck entrances and to build a parking lot specifically for MIT Medical users headed to E23 (25 Carleton St)

* Single-lane closure on Amherst Street at the intersection of Amherst & Carleton to excavate and install sanitary piping and manholes

* Minor modifications to the loading docks behind E38 (292 Main St), E39 (290 Main St), and E48 (238 Main St) to accommodate construction vehicle circulation

* Temporary curb cuts and sidewalk modifications at the corner of Carleton St & Charlotte's Way, behind E39 (290 Main St) and behind E40 (1 Amherst St)

If you have any questions regarding the construction work on site, please contact Alison Crowley at: acrowley@mitimco.mit.edu.

To download the September 2016 construction activities map below, please click here.

Welcome to Kendall Square at MIT!

Thank you for visiting Kendall Square at MIT's construction updates website. We're using this platform to help the community easily find information about construction occurring on Carleton, Hayward, Wadsworth, and Amherst Streets, as well as project plans, documents, and updates to the project status.

Please add a comment or question in the box to the right or visit the Comments section to share your questions with us. We will do our best to respond to you as quickly as possible! You can also follow the project to receive email notifications about new updates.
